Everything up to setting the adapter is recoverable. If the pour goes badly you can scrape it out and start over. The half hour after the adapter goes in is the only one-way part of the build, so I designed the sequence to push everything else off the clock.
Choosing the sequence
I considered two sequences. The first was to pour around a suspended adapter: hang the assembly from a crossbar, pour around the rods, done. But concrete has to travel down through a ½″ annular gap and then flow back underneath an 11″ disc. With aggregate in the mix, it will not fill reliably, and a void directly under the bearing surface defeats the point of using the rotor to spread load.
The second was to pour, then insert: screed to ½″ below the form rim, then press the adapter down into the wet surface until paste squeezes out around the rim. You know it is solid underneath because you put it there.
I chose the second. The ½″ figure comes from displacement: an 11″ rotor bedding about ½″ into a 12″ tube displaces roughly ½″ of concrete, so the level arrives at the rim exactly as the rotor seats.
Holding the cage

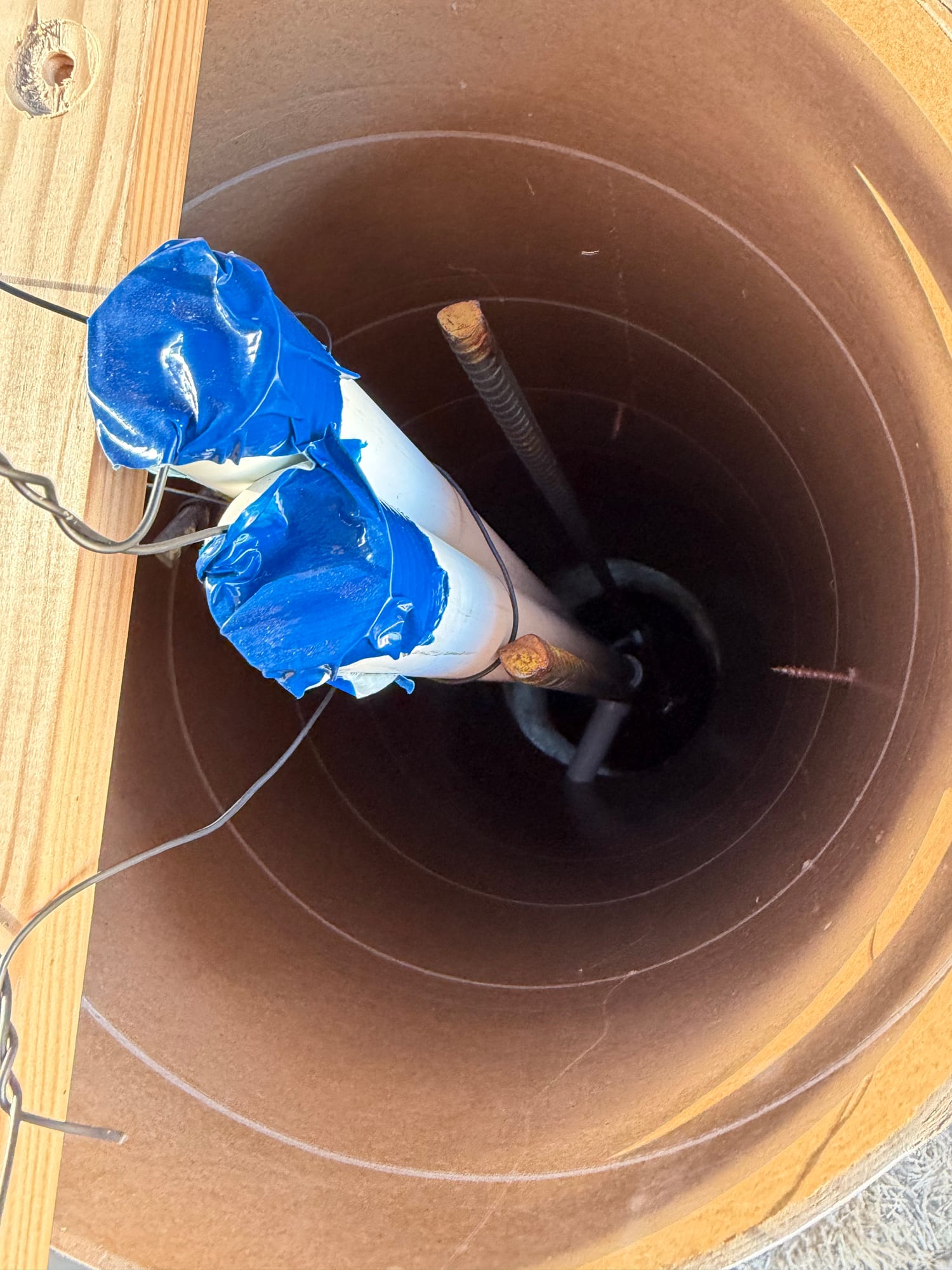

With pour-then-insert, the rods are not in place during the pour, so there is nothing to tie the cage to. The cage hangs from a stick laid across the form rim on three or four doubled tie wires; the rim is free until the adapter goes in.
Once the cage is surrounded by wet concrete, the concrete holds it. Snip the wires, lift the stick off, and set the adapter into a clear rim.
Height off the bottom is set by 3″ dobie blocks, or by placing a 4″ base lift of concrete and setting the cage into it while still plastic. Never use wood, brick or fieldstone: wood rots and leaves a void, and brick is weaker than the concrete around it.

The template bar
The template bar is a temporary wooden bridge (two 2×4 uprights screwed to the deck joists, one crossbar between them) that holds the adapter at the right height and orientation.
The crossbar passes through the gap between the two rotors. A 2×4 laid flat is 1½″; the spacer gap is larger (2½″ as built). So the top rotor rests on the bar and the whole assembly hangs there, hands-free.
It sets height, level and rotation at once, because the bar can only sit one way through that gap.
Brace it properly. Two uprights and a crossbar form a rectangle, which can fold flat. One diagonal from near the top of one upright to the base of the other makes it a triangle. Add a kicker perpendicular to that, or the frame is stiff one way and floppy the other. Use two screws at each joint, because a joint with one screw can pivot.

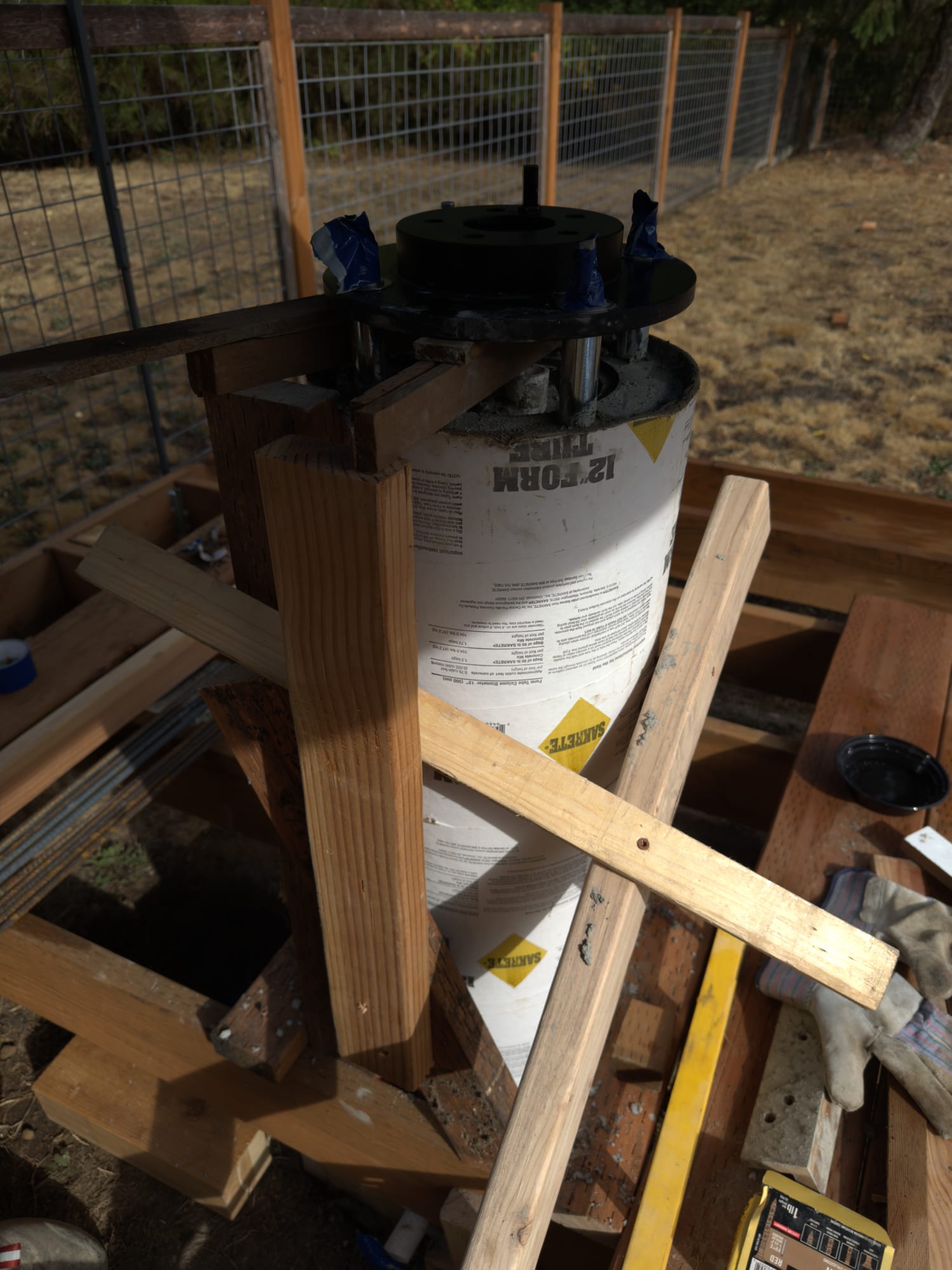

Grab the crossbar and push hard in all four directions, then twist. It should feel dead, because any movement in the frame during the pour ends up in the pier.
One caution from my build: do not let the form tube carry the load. Cardboard feels solid dry, but with 200 lb of wet concrete pressing outward it softens, and screws in wet cardboard hold very little. The uprights must go into solid joist.

Pouring
- About 12 bags of 60 lb high-strength mix for a 12″ form to this height.
- Mix on the stiff side of soupy. Ratio matters more than the extra bag.
- Place in ~12″ lifts, rodding each to release air and tapping the form sides.
- Watch the cage. If it shifts, stop and reset before continuing.
- Stop ½″ below the rim.
- Screed reasonably flat, snip the hanger wires, lift the stick off.
Tape the projecting rod threads before you pour. Cured concrete in thread roots is miserable to clean out.
Setting the adapter
- Lower it straight down, no rocking side to side; rocking is what pushes the cage over.
- Press until the disc beds and paste squeezes out all around.

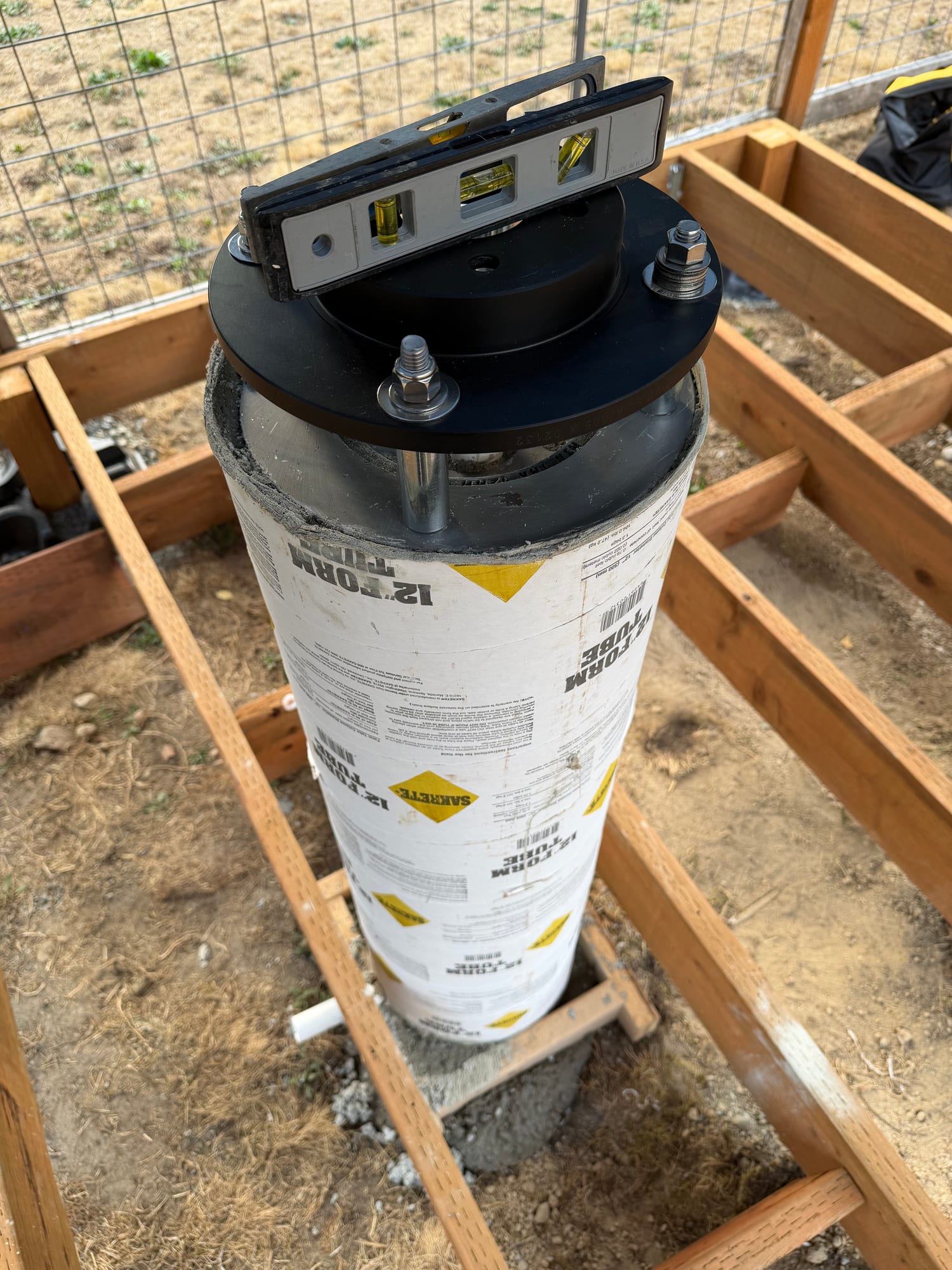

- Level on the rotor itself, at 0° / 45° / 90° / 135°. On a round plate, checking only 0 and 90 can hide a diagonal tilt.
- Sight the index rod to the north stakes.
- Plumb the rods.
- Re-check all three every 10 minutes for the first half hour. Concrete settles and things drift.
- Slope the exposed surface very slightly away from the rotor so water sheds.
As built, I measured the gap at 2½″ at north, east, south and west. The same at all four points, so the adapter sits level.

Curing, and when to strip
- Do not touch it for 24 hours.
- Cover with plastic and keep it damp for at least 3 days. Concrete cured wet ends up substantially stronger, on the order of 30–50% over air-dried.
- At 24–48 hours: back out any screws holding the template bar and slide the crossbar out. While it is attached it links a green pier to the deck frame, and every footstep telegraphs in.
- Leave the form tube on through day 7. It is doing a second job as a curing jacket, holding moisture against the concrete.

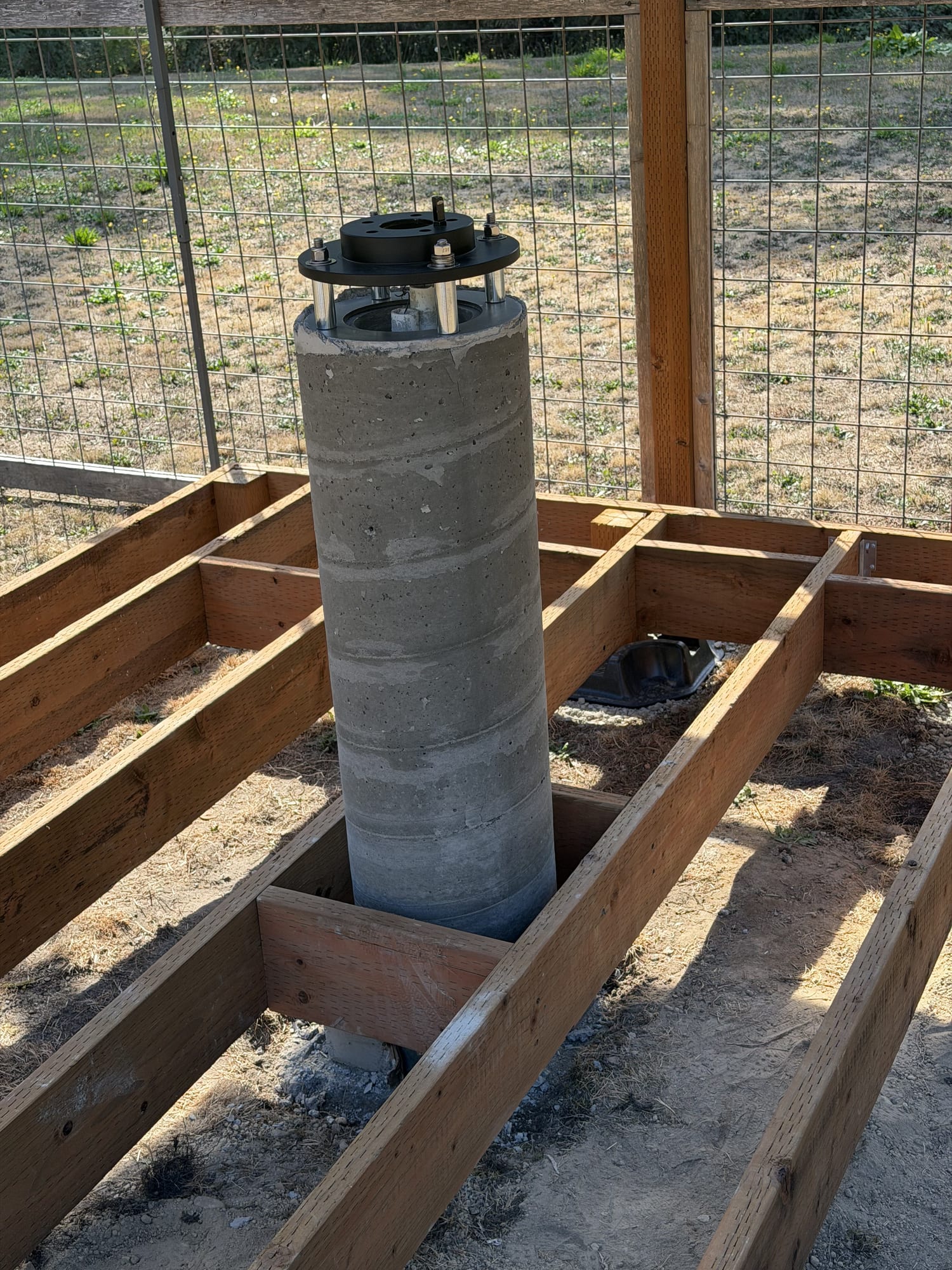

- Strip at 7 days. It should peel in a spiral. Do not lever against the concrete edge; the arris chips easily at that age.
What I did: I took the form off at 3 days. It wasn't raining much, and I covered the pier at night for about a week. That worked in those conditions. Seven days is still the default to plan around.

Loading it
50–60 lb of mount and scope is a non-issue even at day 7. At that age concrete has roughly 65–70% of its 28-day strength, and the compressive stress from a mount on a 12″ pier is well under 1 psi.
The concern is torque. Bolting the mount down means turning nuts on those rods, so go carefully: hold the nut and turn against the mount, and never grip a rod.
